How to Source Multi-Item Promotional Gift Kits from China

2026-08-11 14:09:21

How to Source Multi-Item Promotional Gift Kits from China

Sourcing a multi-item promotional gift kit from China is more complex than buying several products separately.

A typical project may include drinkware, notebooks, pens, bags, umbrellas, power banks or apparel. These items can come from different supply chains, use different materials and require different branding methods. The main challenge is keeping the entire kit consistent in color, logo execution, quality and delivery timing.

For distributors, importers, event agencies and corporate gift suppliers, the best approach is to manage the project as one coordinated sourcing program.

Start with One Project Specification Sheet

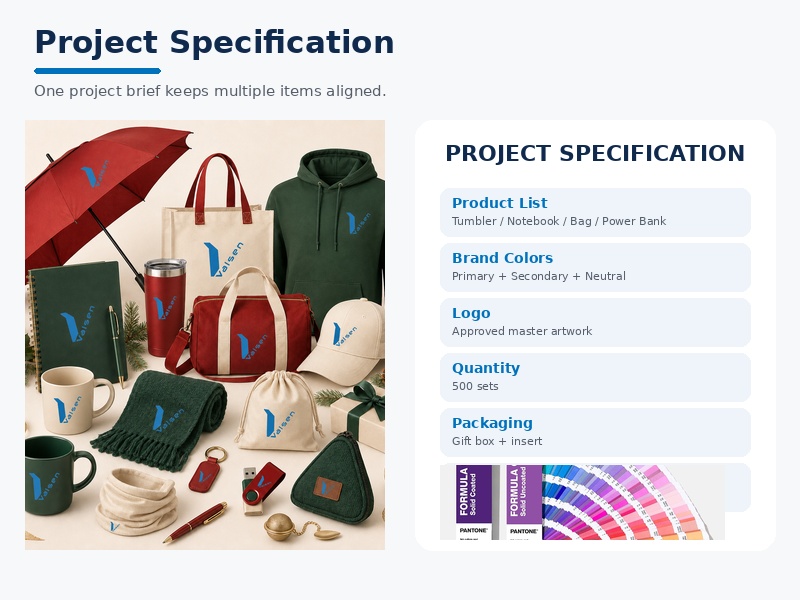

Before requesting quotations, create one specification sheet for the complete kit.

It should include:

  • Product list
  • Quantity per item
  • Total number of sets
  • Target budget
  • Brand colors
  • Logo files
  • Preferred logo position
  • Packaging requirements
  • Event or delivery date
  • Destination market

A unified specification helps reduce misunderstandings when different product categories are being sourced and customized at the same time.

Confirm the Logo Method for Each Product


Different materials require different decoration methods.

For example:

Product

Common Branding Options

Tumbler

Laser engraving, printing

Notebook

Debossing, foil stamping, printing

Fabric bag

Screen printing, heat transfer

Cap

Embroidery

Power bank

Pad printing, UV printing

Umbrella

Panel printing

 The goal is not to use exactly the same decoration process on every item. The goal is to keep logo size, placement and overall visual style consistent across the full set.

Before sampling, confirm the approved logo artwork for each product.

Separate Individual Samples from the Complete Set Sample


For multi-item projects, buyers should usually review samples in two stages.

Individual Product Samples

Each item should first be checked for:

  • Material
  • Size
  • Color
  • Logo position
  • Decoration quality
  • Function
  • Surface finish

Complete Gift Set Sample

After the individual products are approved, the complete kit should be assembled and reviewed together.

This stage helps identify issues such as:

  • One product appearing noticeably different in color
  • Logo sizes looking inconsistent
  • Products not fitting the packaging correctly
  • One item appearing lower in quality than the others
  • Unexpected weight or space problems

A complete set sample provides a more realistic view of the final customer experience.

Use a Clear Color Approval Method

Matching brand colors across different materials can be difficult.

The same color may look different on:

  • Metal
  • Plastic
  • Fabric
  • PU
  • Paper

A practical method is to define:

  • Primary brand color
  • Secondary color
  • Neutral supporting color
  • Approved logo color

Where possible, provide Pantone references or physical color samples.

For some products, an exact visual match may not be realistic because of material differences. In these cases, the goal should be controlled brand consistency rather than forcing every product to appear identical.

Coordinate QC at Two Levels


Quality control should also be divided into two stages.

Individual Product QC

Check:

  • Product dimensions
  • Material
  • Color
  • Logo
  • Function
  • Surface finish
  • Quantity

Final Assembly QC

After all items are collected and packed together, check:

  • Correct product combination
  • Color consistency
  • Logo placement
  • Packaging fit
  • Insert security
  • Missing items
  • Final set appearance
  • Carton labeling

For Category 3 projects, Valsen supports promotional product sourcing, customization and project coordination. Different product categories may come from different supply chains, so the key value is managing specifications, sampling, QC and final assembly as one coordinated project rather than treating every item as if it were produced by one factory.

Check Packaging Size and Shipping Volume Early

Packaging is often underestimated in multi-item projects.

A set containing a tumbler, umbrella, notebook and power bank may require a much larger box than expected.

Before confirming the final combination, consider:

  • Gift box dimensions
  • Insert structure
  • Product protection
  • Total set weight
  • Number of sets per carton
  • Carton dimensions
  • Shipping volume
  • Destination market

Large packaging can significantly affect freight cost, especially for air shipment.

For event-based projects, packaging should therefore be evaluated before mass production, not after all products are finished.

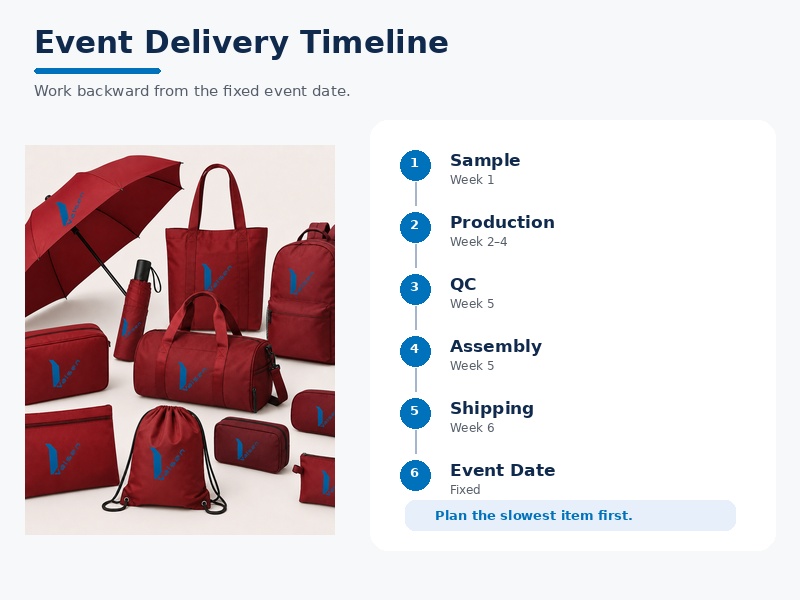

Work Backward from the Event Date


If the gift kit is needed for a trade show, conference or corporate event, the delivery date is fixed.

The project should be planned backward from that deadline.

A typical sequence is:

  • Product selection
  • Quotation confirmation
  • Artwork approval
  • Individual sampling
  • Sample revision if required
  • Mass production
  • Individual QC
  • Complete set assembly
  • Final QC
  • Packing and export delivery

Products with longer lead times should be identified early.

A delay in one item can delay the entire gift set.

What Buyers Should Send Before Requesting a Quote

Prepare:

  • Product list
  • Quantity
  • Budget range
  • Logo files
  • Brand colors
  • Packaging preference
  • Event date
  • Required delivery date
  • Destination
  • Reference images if available

The more complete the project brief, the easier it is to identify potential branding, timing and packaging issues before production starts.

Final Recommendation

Sourcing multi-item promotional gift kits from China requires more than finding separate suppliers for separate products.

The key is to coordinate product specifications, logo methods, color approval, samples, quality control, packaging and delivery under one project plan.

Send your item list, quantity, event date, destination and branding requirements for a coordinated sourcing plan.
